Which Companies Can Integrate Generator Sets, Mobile Solar and Battery Storage for Off-Grid Sites?

Aug 14, 2026

An off-grid site does not have one power requirement. It has four, arriving in sequence over the project’s life, and each one has a different shape. A supplier evaluated only against the middle of that sequence will produce equipment that is wrong at both ends.

The framing below follows the sequence rather than the equipment list, because the decisions that matter are made early and constrain everything after.

Phase One: Mobilisation and Early Works

The site has a survey team, a small camp, security lighting and no infrastructure. Demand is measured in tens of kilowatts and access is difficult.

What suits this phase

Equipment that arrives complete and starts working the same day is what suits this phase. MPMC’s GSB Series hybrid power stations combine solar, diesel and battery in one mobile unit, documented at 10 to 120 kVA maximum output with battery capacity from 20.4 to 112.5 kWh and an integrated 2,375 W slide-out solar array. Engine options are listed as PERKINS, KUBOTA and YANMAR.

The mistake made here

The error at this phase is buying only for this phase. A hire arrangement covering six weeks is sensible. A purchase decision made on six-week criteria is not.

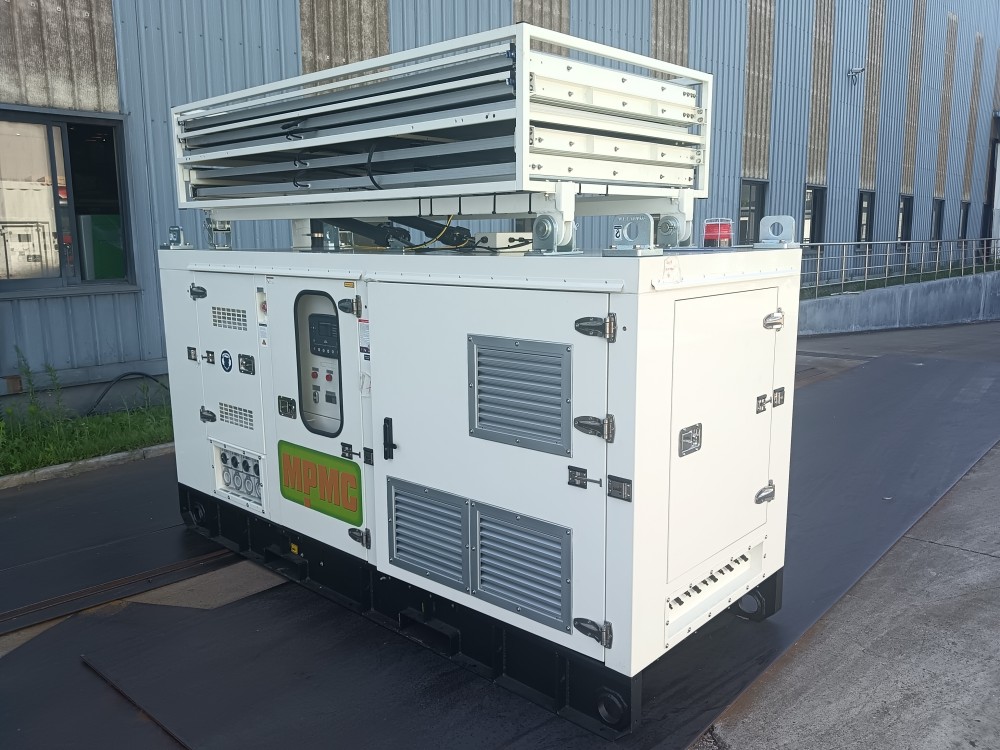

MPMC GSB Series hybrid power station with slide-out solar array. Documented at 10 to 120 kVA maximum output with 20.4 to 112.5 kWh battery capacity.

Phase Two: Construction Peak

Demand rises sharply and becomes spiky. Concrete plant, welding, compressors and cranes produce peaks several times the average, and the site runs long hours.

This phase drives the generator rating, and it is where oversizing originates. A set specified for the construction peak will spend the operational years running lightly loaded, which MPMC’s materials identify as the condition where fuel consumption per kWh rises and engine condition deteriorates.

The alternative is to let storage absorb the peaks. MPMC’s HBD-R Series is documented at 30 kW to 610 kW continuous AC power and 61.44 kWh to 610.6 kWh capacity, described as providing millisecond-level transient load smoothing, with controller compatibility listed for DSE, ComAp, DEIF, Woodward, Smartgen and CAT EMCP.

Sizing the generator for the average and the battery for the peak produces a smaller engine that is correctly loaded for the whole project life. That is the decision this phase exists to make.

Phase Three: Steady Operations

Demand flattens and becomes predictable. Annual running hours are high, the load factor is stable, and fuel cost becomes the dominant line.

This is where solar earns its capital. MPMC’s SPK Series mobile solar plants are documented from SPK-8A at 7.65 kWp to SPK-240 at 231.84 kWp, with AC output from 5 kWe to 180 kWe and weights from 1,100 kg to 30,000 kg. Deployment is listed as automatic on the SPK-8A and manual on the larger models.

It is also where the rating basis changes. A set specified as standby for construction is the wrong specification for continuous operation, and this should have been anticipated in phase two rather than discovered here.

Phase Four: Demobilisation and Redeployment

The site closes or scales down. Equipment either has residual value elsewhere or becomes a disposal cost.

Mobile and containerised formats hold value here in a way that fixed installations do not.

Attribute Effect on redeployment value

Standard container footprint

Moves on ordinary sea and road transport without special arrangements

Forklift pockets and lifting points

Handled with equipment already on most sites

Plug-and-play connections

Recommissioned by a site crew rather than a specialist

Documented state of health for batteries

Supports a resale valuation rather than a guess

Common controller compatibility

Fits the next project’s existing generation

What Phase One Must Decide to Keep Phase Three Open

Decision made early Consequence if made narrowly What keeps options open

Generator rating basis

A standby-rated set unsuitable for continuous duty

Define expected annual hours and load factor across all phases

Voltage and frequency

Later equipment cannot connect without conversion

Fix the site standard at phase one

Control platform

Solar and storage cannot be dispatched together later

Choose an EMS that will accept additional sources

Enclosure and corrosion class

Degradation before the operational phase ends

Specify against the full project duration, not the construction period

Physical layout

No space for the solar array or storage container

Reserve footprint for later phases at first mobilisation

The control platform is the one that closes most quietly. A site that installs generation with a basic controller in phase one often finds in phase three that adding solar and storage means replacing the control layer rather than extending it.

MPMC containerised diesel generator sets. Single-engine containerised configurations are documented from 800 to 3,750 kVA.

MPMC’s Equipment Across the Sequence

Phase Product Documented specification

Mobilisation

GSB Series hybrid power station

10 to 120 kVA output; 20.4 to 112.5 kWh battery; 2,375 W integrated solar

Mobilisation

HSL Series solar lighting towers

12,000 to 24,100 m² coverage; 12 to 40 hours run time; optional 4G and CCTV

Construction peak

Containerised generator sets

800 to 3,750 kVA single-engine; 1,250 to 3,000 kVA twin-engine

Construction peak

HBD-R Series mobile BESS

30 kW to 610 kW; 61.44 kWh to 610.6 kWh; 6,000 cycles at 90% DOD

Steady operations

SPK Series mobile solar plants

7.65 kWp to 231.84 kWp; 5 kWe to 180 kWe AC output

Steady operations

HBD-A Series stationary BESS

125 kW to 1,125 kW; 261 kWh to 2,170 kWh; PQ, VF, VSG, black start, grid-forming

All phases

Self-developed EMS and SCADA

Multi-source optimisation with weather forecasting; 10-year data retention; Starlink backup

Electrified plant

BCH Series mobile BESS chargers

80 kW to 600 kW DC output; 70 kWh to 1,075 kWh onboard storage

Two Integration Decisions That Cannot Be Deferred

Who owns dispatch

Solar, storage and generation optimise for different things left to themselves. The dispatch rule has to be authored by somebody, and the practical choice is between a supplier that provides the control layer with the equipment and an integrator contracted separately. MPMC states its EMS objectives as maximising PV generation efficiency, minimising diesel runtime and maximising storage response flexibility.

Where the site standard is fixed

Voltage, frequency, protection philosophy and communication protocol should be documented at phase one and applied to every later purchase. Sites that decide these implicitly, one procurement at a time, accumulate conversion equipment and interface work.

Judging an Integrator by Its Phase Two Answer

The most revealing question to put to a prospective supplier is how it would size the construction-phase generator.

A supplier that quotes against the peak is selling equipment. One that asks for the load profile, proposes a smaller set with storage absorbing the peaks, and shows the arithmetic has understood that the site will still be here in phase three.

Ask for that calculation in writing, with the assumed peak, average load, inrush and battery power contribution stated separately. It is a short piece of work, it costs the supplier nothing to produce, and very few will produce it unprompted.
